Capital Projects

Kearsley Families,

It is our mission to provide our students and families with the best possible education while creating safe and innovative learning environments for every single Kearsley Hornet.

It’s truly an exciting time in our district as we have already broken ground on our initial phase of the May 2022 Bond project improvements.  I want to provide you with an update of some of the building projects we’ve completed recently and those that are scheduled for completion in the near future.  We have worked hard to leverage funding from a variety of sources to ensure we can deliver upon all the projects included in the May 2022 bond scope and well beyond.

Below you will find a summary of the largest improvements that have been recently completed along with those scheduled for completion in the future.  Additionally, we have included the funding source so that you can see exactly where these dollars are coming from.  We are committed to being good stewards of our community resources and maintaining transparency about what has taken place and what’s coming next.  Definitions with further explanation about the various funding sources are included at the end of this document.

If you have any questions, please feel free to contact me at any time.  Thank you for your support and partnership in your child’s education.

Sincerely,

Paul Gaudard, Superintendent

Graphic, construction hornet

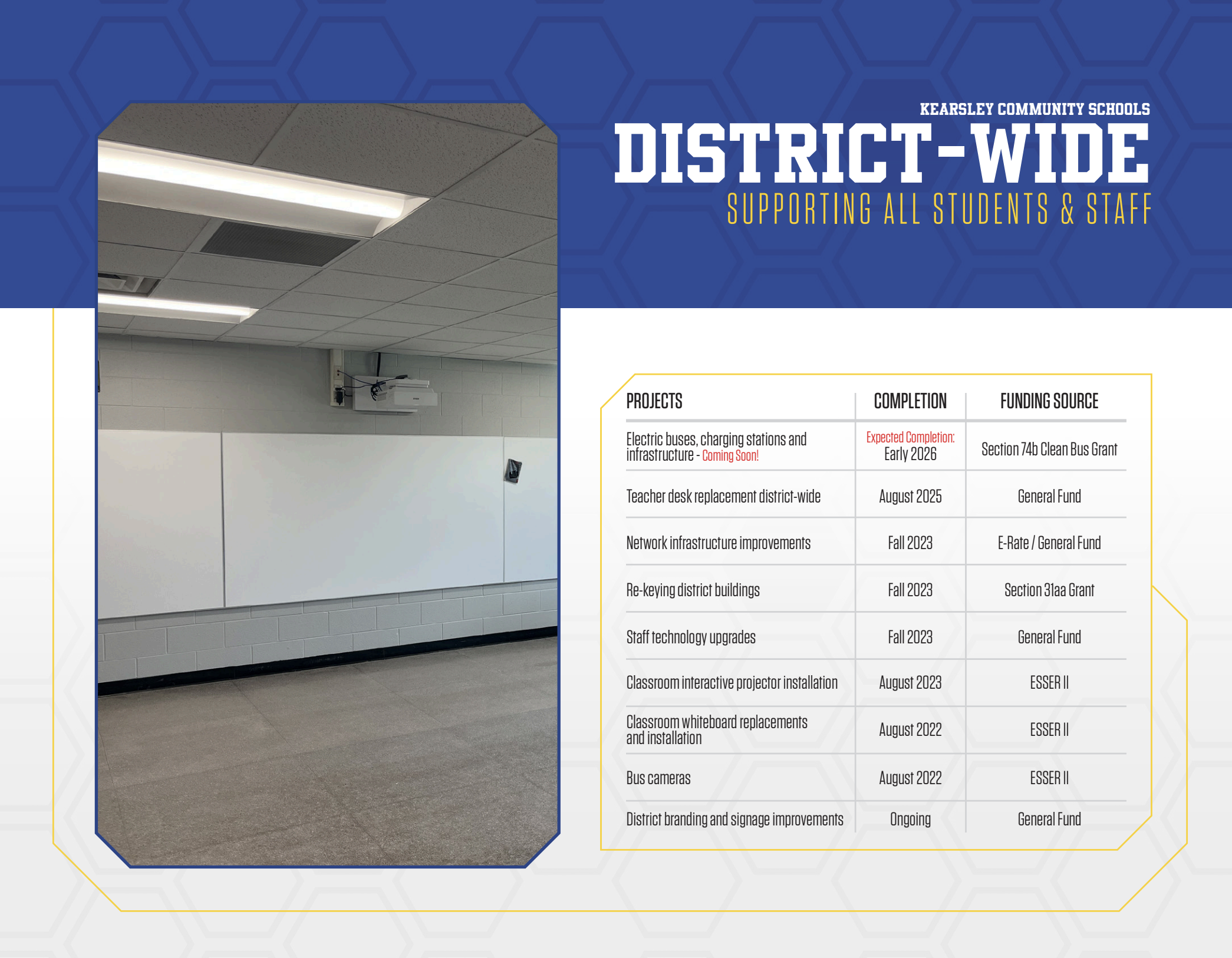

Project Updates

Summer 2022 Projects

Completion

Funding Source

Classroom whiteboard replacements/installation

Summer 2022

ESSER II

KHS doors, windows and exteriors

Fall 2022

Sinking Fund

Pumpkin Patch parking lot replacement

Summer 2022

Sinking Fund / Pumpkin Patch Fund

Pumpkin Patch window / door replacement

Spring 2023

Sinking Fund / Pumpkin Patch Fund

Dowdall / Fiedler partial roof replacement

Summer 2022

Sinking Fund

Dowdall media center renovation

Summer 2022

Sinking Fund

KHS football scoreboard

Summer 2022

General Fund

Previous Slide
Next Slide
Family Movie Night using new scoreboard

Summer 2023 Projects

Completion/Expected Completion

Funding Source

Classroom projector installation

Fall 2023

ESSER II

Fiedler cafeteria addition

September 2023

Capital Projects Fund/Food Service Fund

Fiedler exhaust fan replacement

September 2023

General Fund

KHS media center renovation

November 2023

General Fund / Food Service Fund

KHS plumbing upgrades

Summer 2023

Sinking Fund

KHS track replacement

August 2023

Sinking Fund

KHS steam boiler replacement

October 2023

Sinking Fund

Re-keying of most district buildings

Fall 2023

Section 97 Grant

Network infrastructure improvements

Fall 2023

E-rate / General Fund

Staff technology refresh

Fall 2023

General Fund

Previous Slide
Next Slide
Fiedler cafeteria completed

Summer 2024 Projects

Expected Completion

Funding Source

AMS secure entrance / office remodel

Fall 2024

Capital Projects Fund

AMS re-keying

Fall 2024

Section 31aa Grant

Dowdall multi-purpose center/secure entrance/office addition, windows & classroom renovations

Fall 2025

Sinking Fund / Capital Projects Fund

Fiedler secure entrance

Fall 2024

2022 Bond

Weston secure entrance

Fall 2024

2022 Bond

Weston parent loop expansion

Fall 2024

2022 Bond

Future Projects

Expected Completion

Funding Source

AMS locker room renovations

2022 Bond

AMS media center renovations

2022 Bond

AMS science lab renovations

2022 Bond

Classroom furnishings

2022 Bond

KHS auditorium lobby bathroom renovation

2022 Bond

Robotics lab renovation at Burgtorf

2022 Bond

Weston partial roof replacement

2022 Bond

Multi-Year Projects

Expected Completion

Funding Source

Community recreation center

Winter 2024-2025

2022 Bond*

Previous Slide
Next Slide
Students ground breaking for Community Recreation Center

Definitions:
